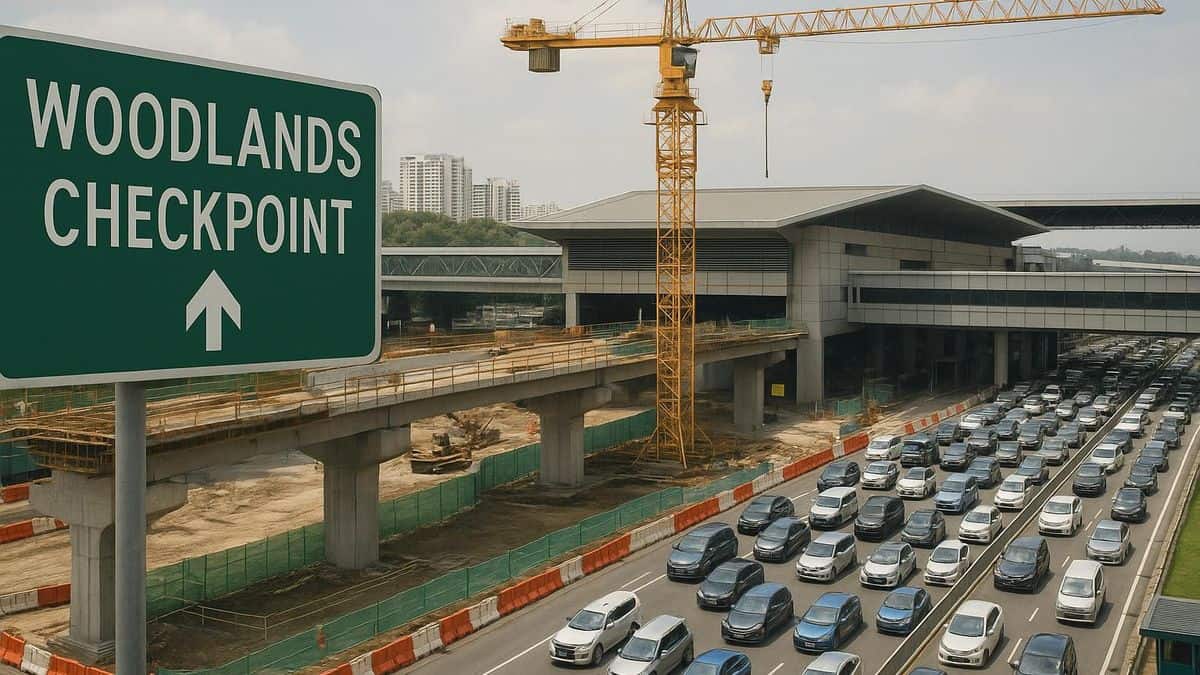

Massive Woodlands Checkpoint Redevelopment: 60-Min to 15-Min Crossing

Massive Woodlands Checkpoint Redevelopment: 60-Min to 15-Min Crossing
Image Source: Artist Impression
  1. Woodlands Checkpoint redevelopment and extension in phases over 10 to 15 years.
  2. Record high 376,000 travellers crossed on 20 December 2024 during the year-end school holidays.
  3. New extension, automated clearance systems, and land acquisition from Malaysia announced for smoother traffic flow.

Singapore plans major changes at Woodlands Checkpoint to provide faster and safer crossings as traveller numbers increase.

Overview of Woodlands Checkpoint Redevelopment

As of 4 June 2025, the Immigration & Checkpoints Authority (ICA) announced a long-term Woodlands checkpoint redevelopment and extension plan.

This Woodlands checkpoint redevelopment will happen in phases across the next 10 to 15 years.

The main goal is to solve the constant checkpoint congestion faced at this busy land crossing.

As quoted in an ICA statement, “The Immigration & Checkpoints Authority (ICA) is redeveloping and extending Woodlands Checkpoint (WCP) in phases over the next 10 to 15 years to provide a long-term solution to the chronic congestion at this land crossing.”

According to ICA, the changes are meant for both current congestion and to prepare for higher traffic in the future.

Current Traveller Volume and Future Projections

The number of daily travellers at WCP rose sharply in recent years.

In 2023, daily volume was 269,000 people.

This shot up by 22% in 2024 to 327,000 daily crossings.

  • A record 376,000 travellers used WCP on 20 December 2024.
  • This happened during the year-end school holidays.
  • Average daily crossings may reach 400,000 by 2050.

As stated in the ICA document, “During the year-end school holidays in 2024, a record 376,000 travellers used the WCP on 20 December 2024.”

ICA says the steady rise in traffic makes changes necessary.

The project aims to reduce waiting times and help people clear the border faster.

Phase 1 Construction Plans

Phase 1 of the checkpoint extension will be at the Old Woodlands Town Centre.

Construction works are set to start in the third quarter of 2025.

This stage will focus on new automated facilities for cargo, arriving cars, and arriving motorcycles.

  • Bukit Timah Expressway (BKE) will be extended with a direct route for vehicles exiting WCP.
  • The new route aims to lower congestion on local roads, especially during peak hours.

The plan is aimed at better traffic management and faster clearances.

ICA says automated clearance will be introduced to speed things up.

Benefits of Full Woodlands Checkpoint Redevelopment

The full Woodland checkpoint redevelopment will continue in later phases.

Upgrades will include more clearance checkpoints and retrofitting the existing WCP building.

Average travel time during peak periods is expected to drop from 60 minutes to 15 minutes.

ICA plans to add in-car automated immigration checks, making things even quicker.

  • Security checks will move away from the checkpoint core to lower risk.
  • Holding areas for traffic will be built within the checkpoint.
  • This will help clear jammed BKE lanes and roads nearby faster.

ICA will make use of technology and creative solutions to help both people and cargo move while maintaining border safety.

The aim is a better experience for all travellers.

Land Acquisition Details

ICA did several studies to decide how much land is needed for future traffic and security.

Singapore will acquire two small parcels from the Malaysian Government for the project.

The total area is about 0.79ha.

  • Land parcels are near the middle of the redevelopment profile.
  • They are covered in plants and currently unused.
  • The Singapore Land Authority (SLA) officially announced the acquisition on 4 June 2025.

As quoted in ICA’s media release, “To facilitate the redevelopment and extension of WCP, two separate small land parcels (with a total area of approximately 0.79ha) located near the middle of the redevelopment profile, which are owned by the Malaysian Government, will be acquired by the Singapore Government.”

SLA and ICA will work closely with Malaysia on this process.

The land acquisition is part of the overall Woodlands checkpoint redevelopment plan that aims to improve safety and travel efficiency at the border.

Collaboration with Malaysian Government

Singapore will keep working with the Malaysian Government on the checkpoint extension and land purchases.

This is part of ongoing efforts to strengthen cross-border links and relationships.

  • ICA and SLA released their update together on 4 June 2025.
  • This cooperation is part of the ongoing partnership between the two neighbouring countries.
  • SLA and ICA will work closely with the Malaysian Government through the acquisition process.

Singapore wants to keep borders safe as travel and trade grow more important.
